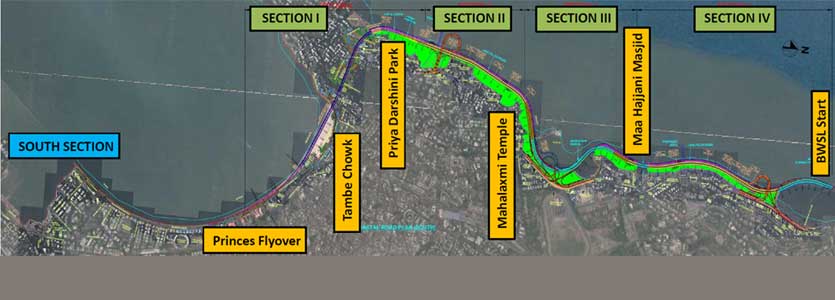

The Coastal Road works are in progress from Princess Street Flyover to Worli of Bandra Worli Sea Link. Current foundation and Superstructure works via excavation, piling, End tunnelling, construction of cut and cover boxes, SWD box drains, pipe extension works, reclamation works and sea wall construction works are primarily in progress.

The summary of progress is as under:

Sr.No Name of work Completed
1 Reclamation area covered100 Ha
2 Sea wall 5142 rmt
3 Pile caps 127 nos
4 Piers 43 nos
5 Tunnel 722m
6 Cut and Cover 100 m
